Interactive Map
November 5, 2026
22
Main Entrance Additional structure
Wood is added in front of the gypsum sheathing to provide anchor points for the front entrance system.

November 2, 2026
21
Brick Apron is laid
A brick apron around the exterior of the building is laid to visually ground the building and protect the structure.

October 22, 2026
20
Gypsum Sheathing applied to exterior of Bridal Suite & Front Wall
Figerglass-faced gypsum sheathing panels are added prior to stucco to protect the building from weather and other damage.

October 16, 2026
19
HVAC is installed
Several HVAC units are delivered and installed on the roof.

October 6, 2026
18
Ballroom Aches Begin Frame To take shape
Arches are one of the aerial elements adding color and character to events. They are positioned 24ft high in the main ballroom.

September 25, 2026
17
Wall sheathing Continues on West Side
Work continues on interior walls in the main ballrooms and exterior walls on the West side of the venue.

September 18, 2026
16
Exterior Framing Begins on West Side
The rooms on the west side of the building are framed up including the green room, groomsmen suite, office, storage room, and kitchen.

September 10, 2026
15
Main Ballroom Framing and Insulation Work Begins
The Main Ballroom framing and insulation is added

September 4, 2026
14
Main Structure is Finished
"Red Iron" is completed so that the interior walls can be framed out

August 20, 2026
13
The main ballroom takes shape
Major elements of the ballroom structure outline its shape and scale.

August 18, 2026
12
structure begins
Vertical construction begins above the slab.

August 8, 2026
11
Full Slab Is completed
The full slab has been poured and structural iron will begin to be delivered to the site.

August 3, 2026
10
Front Slab is Poured
The front half of the building slab is poured while in-ground continues at the rear of the building.

July 30, 2026
9
site is prepared for slab
Vapor barriers and steel mesh are laid to prepare the site for the first of two concrete pours for the slab.

July 23, 2026
8
Grade Beams are poured
Grade beams connecting the footings are dug and poured. Additional sub-grade electrical work continues in the main ballroom

June 27, 2026
7
Structural Footings Are Poured
Additional structural reinforcements and electrical work will be complete before the full slab is poured

June 23, 2026
6
Structural Footings Are Dug
These footings will be filled with concrete and support the weight of the building's structure

June 12, 2026
5
Plumbing and Electrical service are roughed in
Footings and other elements will be added to support the building's structure

June 5, 2026
4
Slab/Building Perimeter is formed
Plumbing and electrical work will be done before the slab is poured

May 6, 2026
3
Next Step: Forming Slab
The retention pond has been partially dug out and the earth underneath the slab has been compacted for a solid foundation.

April 20, 2026
2
Next Step: Foundation Work
The land at 16405 Jefferson Hwy has been cleared and foundation work will begin soon. Stay tuned for more updates!

March 27, 2026
1

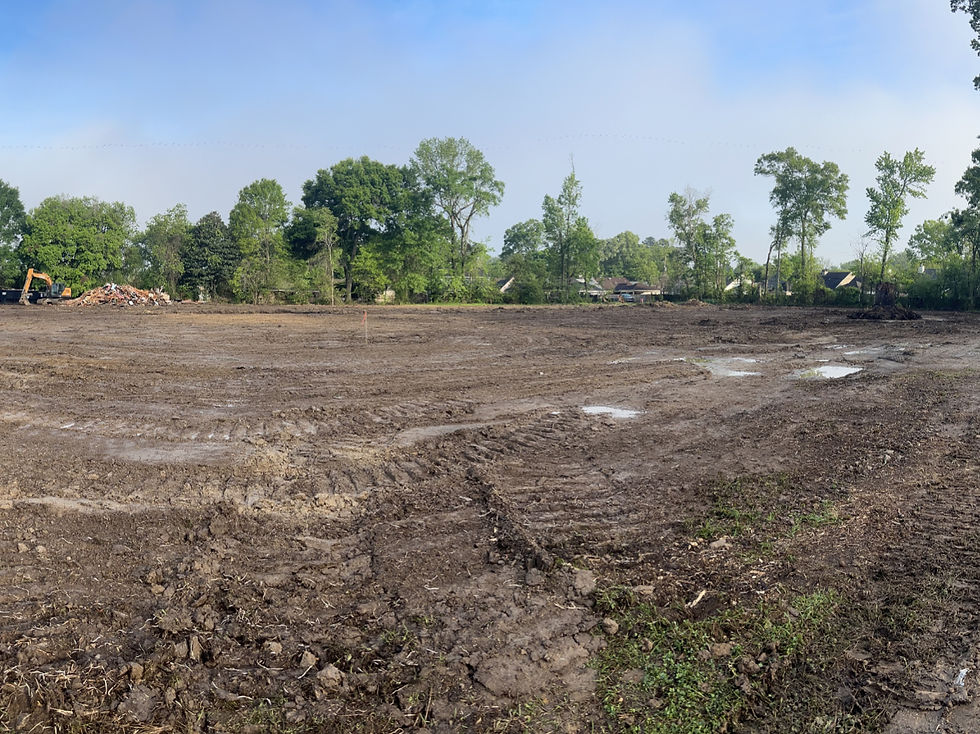

Site work Begins
The land at 16405 will undergo a complete transformation over the next few weeks.

Construction Updates
Aurora Park is set to open in Spring 2027
Next Update Coming Soon
